Parish Hall rethatching completed
Images of the hall’s smart new thatched roof – good for at least 20 years.
Parish Hall Grand Opening after Phase 1 Refurbishment
Her Majesty’s Lord-Lieutenant of Devon (Mr David Fursdon) opened the Parish Hall after the first phase of the Conserve and Improve refurbishments.
Parish Hall rethatching starts
Thatched roofs need rethatching typically every 20-25 years when they are created using wheat straw which is authentic for the Devon area where reed straw is not readily available.

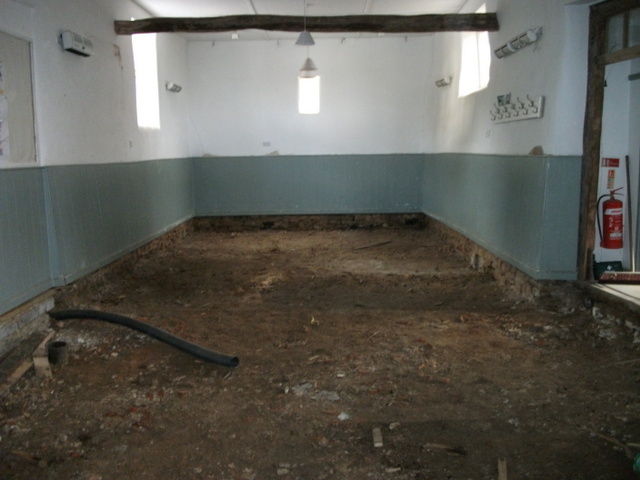

Hall Floor Investigation

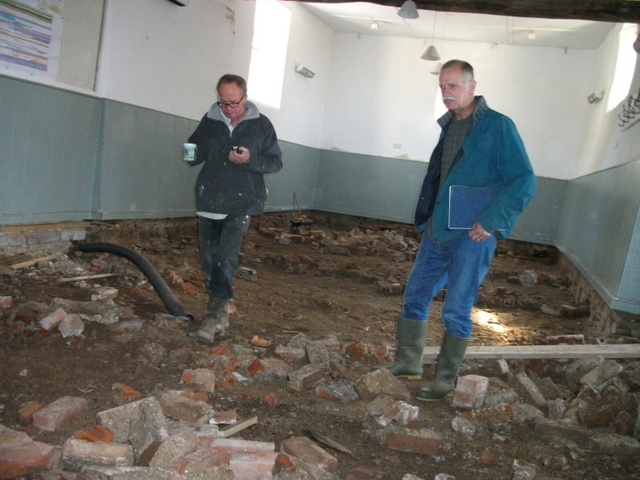

On Sunday 18th October 2015 some members of the Heritage project group investigated the parish hall floor now exposed after removing the wooden floor and joists . With only one day available before the builders started their work the group took on the role of keen amateur archaeologists to gather as much information as possible about the floor before it was sealed by a layer of concrete. The investigation team included:
- Steve Baber
- Martin Bond
- Miya Bond
- Liz Guppy
- Sandy Haughton
After collecting various loose objects the team swept dust and rubble from the southern end of the hall to expose what was thought to be the original floor.
They wrote up their finds on the Report on the Parish Hall Floor Investigation page.

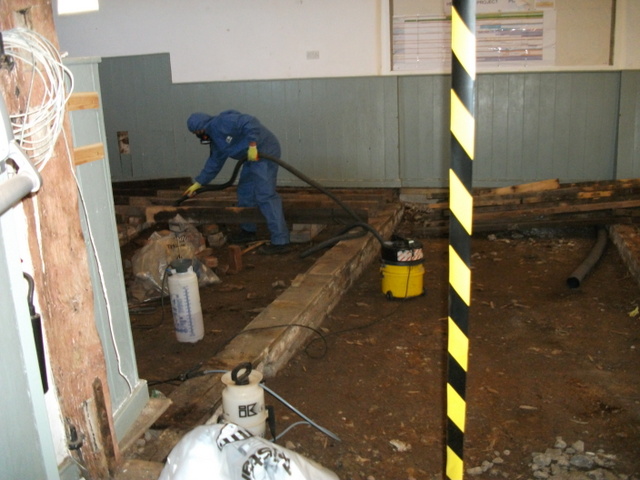

Asbestos removal
Sub contractors ( Asbestos Management Services & Removals (AMS) of Barnstaple). working in protective suits to remove asbestos which was believed to be have been used under the sage.

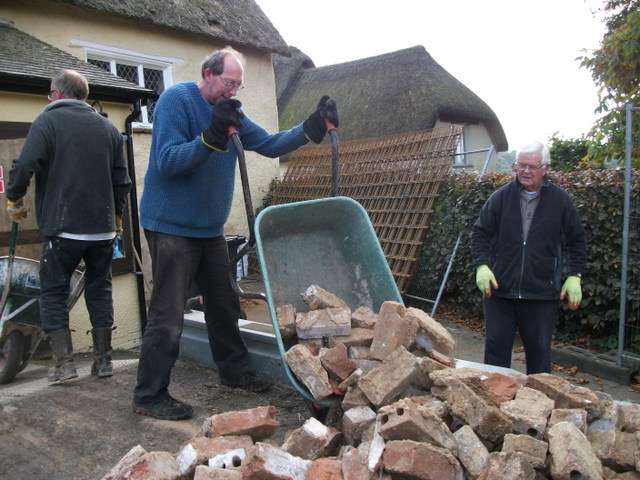

Removing Sub Floor

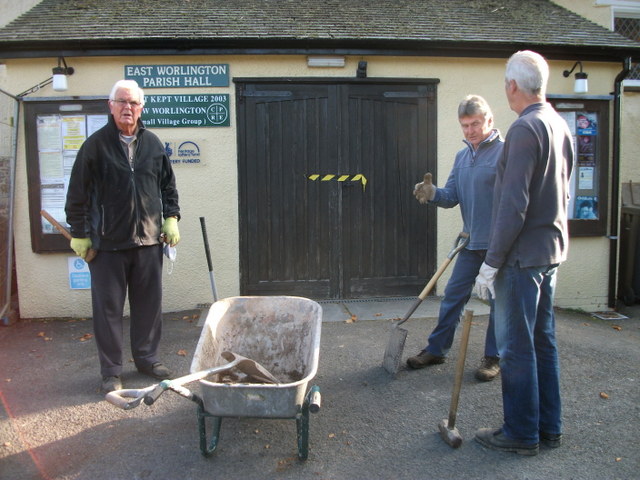

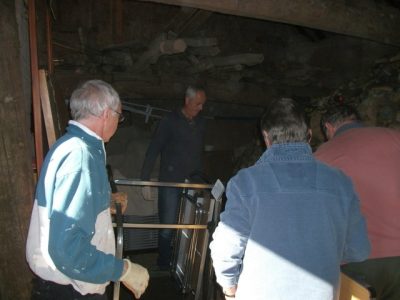

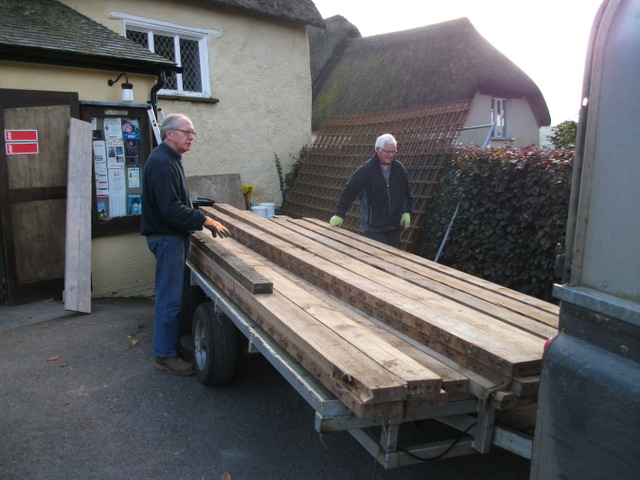

Returning on Tuesday 13 October and again on Thursday 15 October volunteers helped lift the hall sub-floor and store the bricks and joists for re-use where possible.
|
Many thanks to (from left):
|
Not shown in photo:
|
For safety reasons access to the hall on Wednesday was not allowed during the removal of any potential asbestos material was undertaken by Asbestos Management Services & Removals (AMS) of Barnstaple.

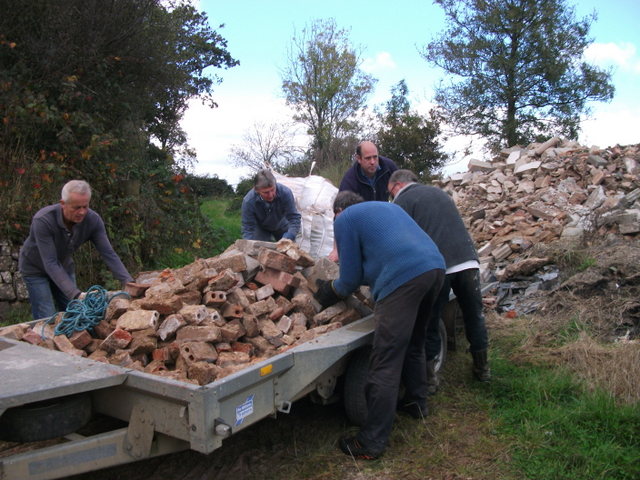

Joists have been stored on Phillip Brown’s farm, and the bircks on West Yeo farm, until they can be re-used.

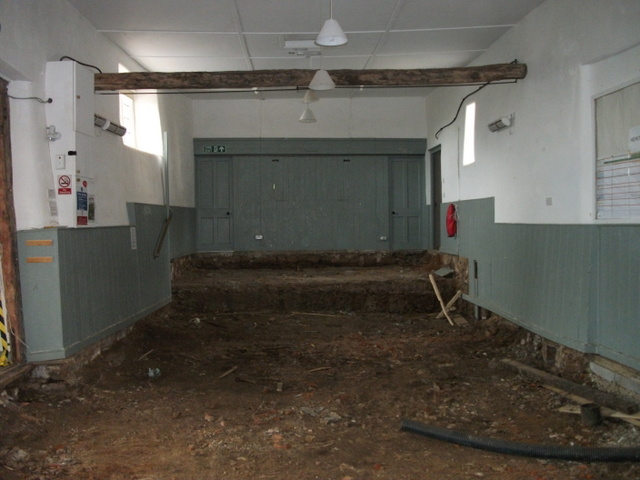

By Thursday afternoon the hall was cleared ready for the builders to start work the following Monday.
Photographs of the work
More photos on our Picassa web site for Tuesday, Wednesday (asbestos) and Thursday.
Lifting the Old Hall Floor

By lunchtime on Monday 12 October, 2015 after the hall had been cleared community volunteers started the on lifting the flooring in the main hall and store room, and removing the stage.
|
Many thanks to (left to right):
|
The first boards were lifted at the south end of the hall. Although a board was lifted by the stage at the same time the team agreed that working from one end of the hall would be more sensible and safer.
no images were found
The team started lifting boards at the south end of the hall. The boards were nailed down and typically the nails stayed in the supporting joists and the boards pulled off the nails. Many boards split or broke as they were lifted and the ones in the south west corner showed extensive signs of rot where the boards abutted the walls.As the boards are to be retained and sold on any nails left in the boards were removed before they went into storage in Campie and Barnabus’ barn.
no images were found

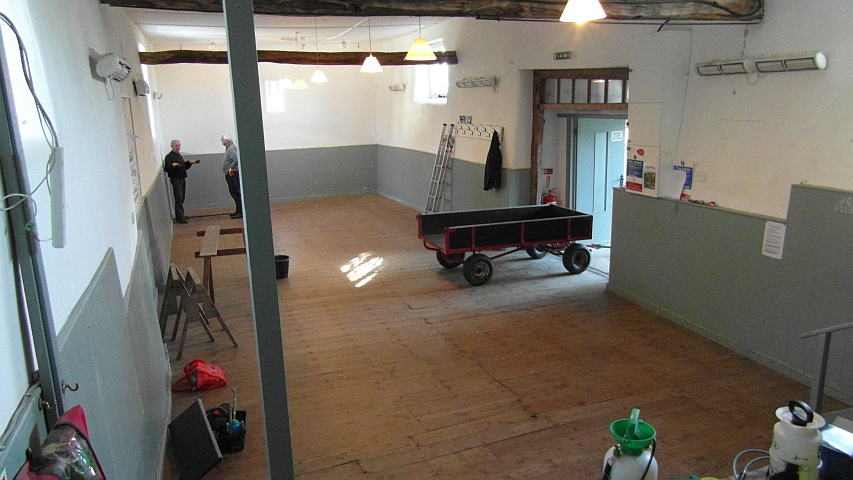

Meanwhile a small crew started in the store room and removed the shelving from the north wall where the heating boiler and underfloor distribution manifold will be positioned. The floor boards in the store room were lifted ready for the builders to lay in the heating pipework. The floor boards were kept in the room and will be relaid once the heating has been comissioned.no images were found
An hour and a half into the work and the discussion over a tea break decides progress is slow but steady.After the tea break and with work finished in the store room, the progress in the main hall picked up as the volunteers worked out the best techniques for lifting boards.
There was some concern that packing under the stage may have been asbestos sheeting so a portable water sprayer was used to damp down any dust.

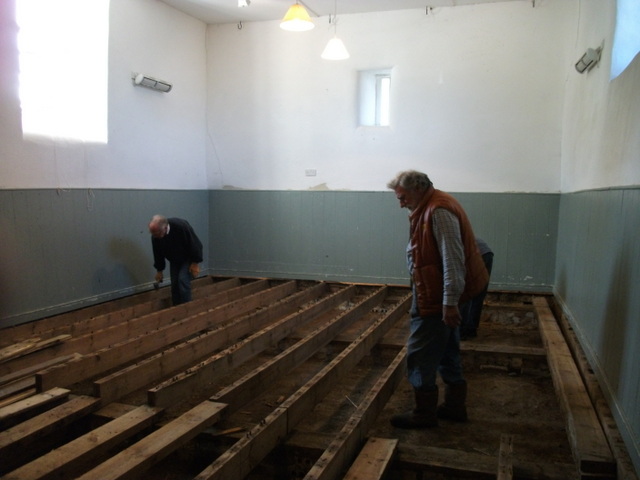

Over a second tea break with chocolate cake the team decided they could finish the floor boards within a couple of hours and decided to keep working to clear the hall that day. They would leave the joists and stub walls for the next day. Work had started around 1:00PM and finished about 6:30PM.

Photographs of the work
Volunteers Clearing the Hall

On Monday 12 October, 2015 a small group of community volunteers met at the hall around 9:30 and started to move the various items out of the store room and the main hall.
|
Many thanks to
|
With help from:
|

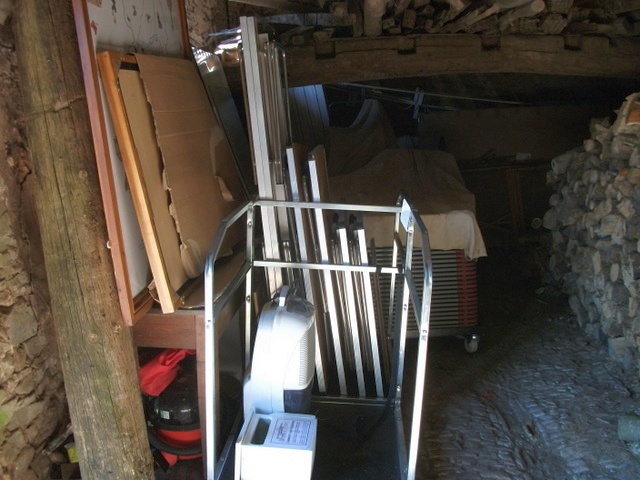

Most the hall equipment was stored in Campie’s Barn, and East Worlington Primary School found a home for the temporary stage and school activity items.
Special thanks to Bob for the use of his large flatbed trolley which made moving items a lot less strenuous than if the team had had to carry everything.
The tapestry wall hangings were carefully taken from the wall and, courtesy of Jean Smyth, taken round to Town Barton Farm and placed on a bed each for the duration of the building works. They will have a quick wash and brush up to get them ready for returning to the hall in the new year.
Images from clearing the hall
Re-routing Hall Electricity Supply
Week beginning 28th September work was started and completed on the re-routing of the electrical supply to the Parish Hall.
The supply previously entered the Hall under the old barn door on the east side of the building and was routed under the floor to the meter and consumer units on in the cupboard adjacent to the Hall door on the west side of the building.
To complete the work on the floor and installation of the underfloor heating the cable had to be moved. The new location for the meter is in the storeroom. As all the Hall electrical circuits currently are fed from the consumer unit in the cupboard in the Hall, and as the work to installing new circuits will not commence until February 2016, a temporary power supply has been laid from the new location of the meter to the existing consumer units.
To relocate the cable required a trench to be dug in ‘Campie’s yard’ and we are extremely grateful to Campie and Barnabas for allowing this to happen in support of the project. The trench was dug on Monday. To gain access to the storeroom from the trench required an access hole to be dug in the floor of the storeroom and under the storeroom external wall. This was completed on Tuesday by Ron Moore and Steve Baber.
On Thursday Dart Electrics were at the Hall to undertake the necessary electrical work in installing the equipment and cable to connect the new power source to the existing consumer units. Western Power were at the Hall and moved the cable to the new location and fitted the meter. By the end of the day on Thursday this part of the work was completed and the electric services and equipment in the Hall were tested and functioned.
Friday saw the backfilling of the trench.
Photographs of the work
More photos on our Picasa slideshow
